Cable applications by project type

Every project pulls from a different mix of the sixteen lines. These pages map the circuit to the cable, the standard and the packing, so that your RFQ starts from the job rather than from a catalogue.

Request a quote

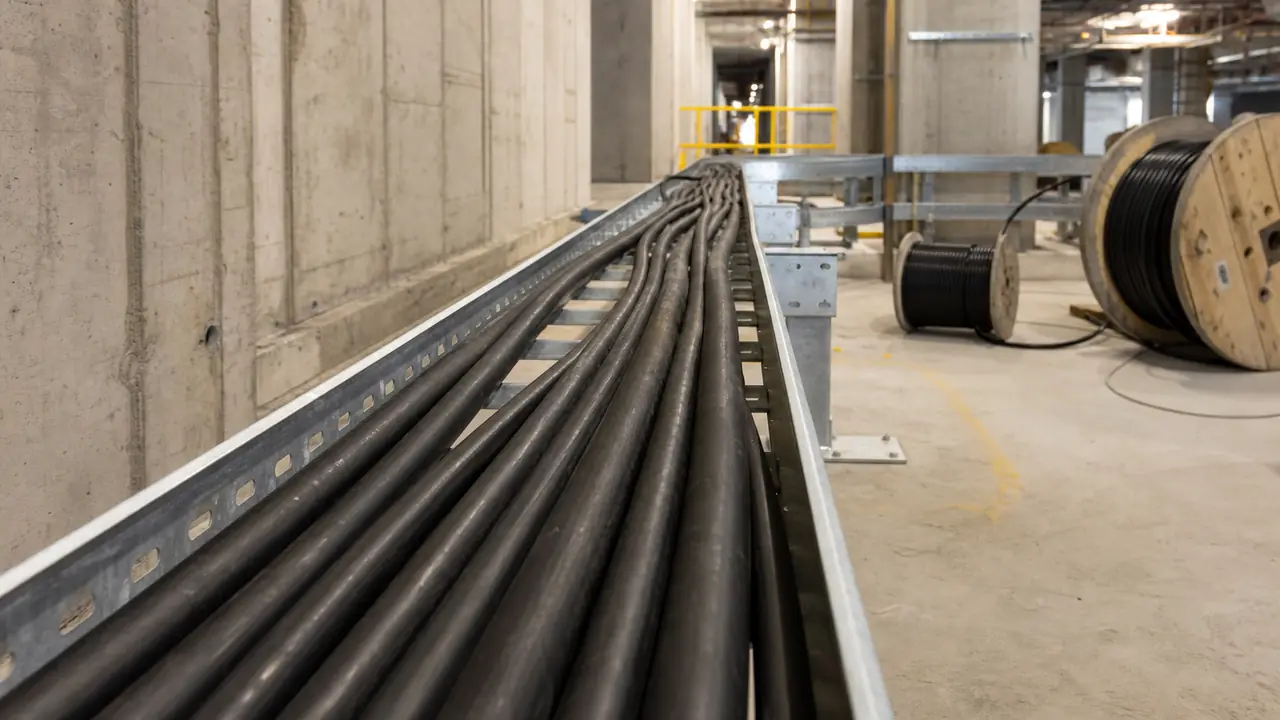

Cable drums of different sizes staged on a project laydown yard for power, solar and fibre cable applications

Start from the job, not the catalogue

A cable order goes wrong most often at the very start, when a buyer describes a product instead of a circuit. 'Four-core armoured cable' can mean a BS 5467 steel wire armoured cable for a UK plant room, an IEC 60502-1 steel tape armoured cable for a Middle East villa compound, or a cable that the site never needed armour on at all. The desk therefore asks what the cable does: which circuit, which installation method, which standard the engineer has written into the specification and how the cable will be delivered to the pulling point. The six application pages below translate those questions into lines, constructions, standards and drum plans.

The pages are written for brand owners, distributors and wholesalers who supply contractors as well as for engineering projects buying direct. They do not size cables. Conductor size and current rating depend on installation method, grouping, ambient temperature, voltage drop and fault level under IEC 60364-5-52, BS 7671 or the NEC as applicable, and are confirmed by the project engineer. The cable sizing guide lists the inputs the engineer will need.

Six project types and the lines they use

Project types mapped to cable lines
Project typeMain linesKey standardsTypical packing
BuildingsBuilding wire, LV power, fire-resistant, flexible cords, LANIEC 60227, IEC 60502-1, EN 50575, BS 6004, TIS 11100 m coils, drums, 305 m boxes
Solar PV farms and roofsSolar PV cable, LV and aluminium power, armoured, MVEN 50618, IEC 62930, UL 4703, IEC 60502-1/-2100 m coils, 500 m drums, large drums
Industrial plantsArmoured, control, instrumentation, LV power, fire-resistantIEC 60502-1, BS 5467, BS 6724, IEC 60331Drums per circuit length
Utility gridsMV power, aluminium, armoured, ADSSIEC 60502-2, IEC 60885-3, IEEE 1222, IEC 60794-4-20Heavy drums, fibre drums
Data centresIndoor fibre, optical fibre, patch cords, LAN, LV power, fire-resistantTIA-568, IEC 61753-1, EN 50575, NEC 770 / 800Reels, 305 m boxes, drums
Telecom and FTTHOutdoor fibre, ADSS, FTTH drop and patch cords, indoor fibreITU-T G.652.D / G.657, Telcordia GR-20, IEC 61753-12 km / 4 km drums, 1 km drop reels

Most real projects touch several rows. The desk builds one spec sheet per construction and one drum plan for the whole order.

What every application page covers

  • Circuit-to-cable table: which line and construction usually serves each circuit, the standard it is made to and how it is normally packed.
  • Standards and market notes: the routes that commonly apply in IEC, UK, EU, US and selected export markets, framed as items to confirm with the project engineer, test lab or AHJ.
  • Drum planning: how lengths per drum, metre marks and drum types are set for that kind of site.
  • Typical risks: the failures the desk sees most often for that project type and the record that catches each one.

Why the cluster depends on the application

China's cable industry is concentrated, and each cluster is strong in different products. Power and special cables point to Yixing and Guanlin in Jiangsu, where wire and cable output passed 100 billion yuan by end-2020 (Jiangsu provincial news site, 2021), to Ningjin in Hebei, recognised for medium and low voltage and new-energy cables, and to Wuwei in Anhui for special cables. Fibre and fibre cable point to Wuhan, whose industry holds more than 25% of the international market for fibre and cable (Wuhan municipal government), and to Qidu in Wujiang. LAN cable and cords point to Humen in Dongguan. A mixed project is often split across two or three partner plants, which is why one drum ledger and one inspection plan matter. See industry clusters.

Drum planning across a project

The cable schedule tells the desk how long each run is. The drum plan turns that into drums: each drum carries one or more full runs with an allowance for termination, so that no joint is needed where the specification does not allow one. Length per drum is limited by drum capacity, weight and the site's handling equipment; the drum type (wooden, steel-wood or steel) follows the weight and the destination. Wooden drums typically take 2-4 weeks to make, so the plan is fixed before production. The packaging and drums page explains drum labels, lagging and end caps.

Common risks across all project types

Three risks repeat across every application. Undersized conductors: regulators have warned about armoured cable whose effective cross-section was up to two sizes below the marking, so the desk compares conductor DC resistance per drum with IEC 60228. Wrong fire class: in the EU the CPR class must be declared on the DoP for the exact construction, and it describes reaction to fire only, not circuit integrity. Certificates that do not cover the product: a listing or approval is held by the partner plant for a specific construction and is checked in the certifier's public database per order.

MOQ and lead time follow the typical ranges on MOQ and lead time and are confirmed in writing for each order. When the mix is clear, send a brief and the desk returns matched plants, reference constructions and a draft drum plan.

Questions buyers ask

Q01Can one order cover several project types?

Yes. A mixed project is normally split into one spec sheet per construction and one drum plan for the whole order. Different constructions may come from different partner plants in different clusters, with one inspection plan and one drum ledger coordinated by the desk.

Q02Do the application pages tell me which cable size to use?

No. Size and current rating depend on installation method, grouping, ambient temperature, voltage drop and fault level under IEC 60364-5-52, BS 7671 or the NEC as applicable. Your project engineer sizes the cable; the desk supplies the construction specified.

Q03What should I send to start an application-based RFQ?

The cable schedule or bill of quantities with run lengths, the standard named in the specification, the destination market, any fire or listing requirement, and the port. The desk then proposes reference constructions, plants and a draft drum plan.

Q04Are the reference constructions final specifications?

No. They are reference models from a partner plant catalogue or public datasheets. The desk turns them into your spec sheet, and every layer, marking text and drum length is confirmed in writing before production.

RFQSend the construction or standard you need, cross-sections, total metres and drum lengths, the reports your market asks for and the destination port. The desk replies in writing with matched factories, a spec sheet and the reference MOQ.
